Hotel furniture replacement is rarely as simple as replacing a few old chairs or tables.
In an operating hotel, renovation normally needs to be planned around the rooms and areas that can be taken out of service without affecting the rest of the property.
In our experience, this means hotel renovation is usually carried out floor by floor, room block by room block, or area by area.
The rooms being renovated are normally treated as a complete renovation package. Furniture, fixed furniture, finishes, lighting and other interior elements may all be updated together so the finished room looks consistent.
The furniture supplier therefore needs to understand more than the furniture itself.
The supplier needs to understand how the hotel is phasing the renovation, how many rooms can be closed at one time, what is being replaced, and how production and delivery need to follow the site's construction programme.
An operating hotel cannot normally close the entire property for renovation.
Instead, the project team decides how many rooms or which areas can be taken out of service at one time.
This may be organised by:
Floor
Room block
Room type
Guestroom wing
Public area
Renovation zone
The exact arrangement depends on the hotel and its operating requirements.
For guestroom renovation, a common approach is to close a defined group of rooms, complete the renovation, reopen them, and then move to the next group.
The furniture replacement therefore follows the construction programme.
It is not simply:
old furniture out → new furniture in
It is:
rooms closed → existing interiors removed → renovation works → furniture installation → inspection → rooms reopened
This distinction is important for both the hotel and the furniture supplier.
We normally look at eight areas before treating a replacement piece as ready for production.
Item | What Should Be Checked |
|---|---|
Dimensions | Overall size, height and critical clearances |
Materials | Solid wood, plywood, MDF, metal and other substrates |
Veneer | Species, grain direction, cut and pattern |
Finish | Stain colour, coating system and sheen |
Upholstery | Fabric, colour, texture, seams and tension |
Foam | Density, firmness and shape |
Hardware | Hinges, runners, mechanisms and fixings |
Construction | Frame, joints, internal structure and load-bearing details |
The important point is that these factors interact.
A lounge chair can have the right dimensions but still look wrong because the fabric or stain is different.
A bench can have the correct colour but feel different because the frame construction or upholstery thickness has changed.
A piece can even look correct when photographed alone but appear obviously different when installed beside ten-year-old furniture.
That is why visual similarity and technical matching are not the same thing.
When a hotel room reaches a renovation cycle, the problem is usually larger than one worn-out chair or table.
After years of operation, different parts of the room age at different rates.
You may find:
Furniture showing wear
Wall finishes becoming dated or damaged
Carpets requiring replacement
Lighting needing upgrading
Fixed furniture requiring refurbishment or replacement
Upholstery becoming worn
Hardware requiring replacement
Guestroom layouts being updated
Replacing only a few loose furniture pieces while leaving everything else unchanged can make the room look inconsistent.
The new furniture may be in better condition, but it can also look noticeably different from the older surroundings.
For this reason, many hotel renovation projects take a whole-room approach.
The objective is not simply to install new furniture.
The objective is to return the room to a consistent, refreshed condition.
From our perspective, this is one of the main differences between hotel furniture replacement and ordinary furniture replacement.
A hotel still needs to generate revenue while renovation is taking place.
That creates a practical limitation.
If a hotel has hundreds of rooms, closing every room at once may not be commercially realistic.
Instead, the project team may agree to renovate a controlled number of rooms at one time.
The number might depend on:
Occupancy levels
Seasonality
Construction progress
Available labour
Site access
Room type
Hotel operating requirements
This is why a hotel may take several years to complete a renovation programme.
The renovation period is not necessarily a sign that the project is slow.
The project may simply be deliberately phased so that the hotel can continue operating.
There is no universal rule that a hotel must renovate an entire floor at once.
The project team may choose a smaller number of rooms depending on the property's operation and the construction scope.
One example from our experience is the Pathumwan Princess Hotel in Bangkok, where more than 200 rooms were renovated over approximately three years.
This project is carried out in small batches. Several dozen rooms are processed each time.Because the project included fixed furniture as well as loose furniture, the site installation stage also required more time.
That is a very different project-management situation from manufacturing furniture for a new hotel that has not yet opened.
Loose furniture can often be removed and installed relatively quickly.
Fixed furniture is different.
Once a renovation includes:
Wardrobes
TV cabinets
Desks
Headboards
Wall panels
Built-in storage
Other joinery
the sequence becomes more dependent on the site construction programme.
The existing furniture may need to be removed.
The wall or floor may need preparation.
Services may need to be relocated.
The new fixed furniture then needs to be installed, adjusted and inspected.
This is why a 30-room renovation phase can take considerably longer on site than simply delivering 30 sets of loose furniture.
For the manufacturer, understanding this difference matters when planning production and delivery.
The furniture supplier should not plan production only around the final completion date.
The supplier needs to know:
When will the first rooms be ready?
How many rooms will be ready at once?
When will the next floor or room block be released?
Which furniture has to arrive first?
Is fixed furniture being installed before loose furniture?
How much storage is available on site?
These questions affect production and delivery.

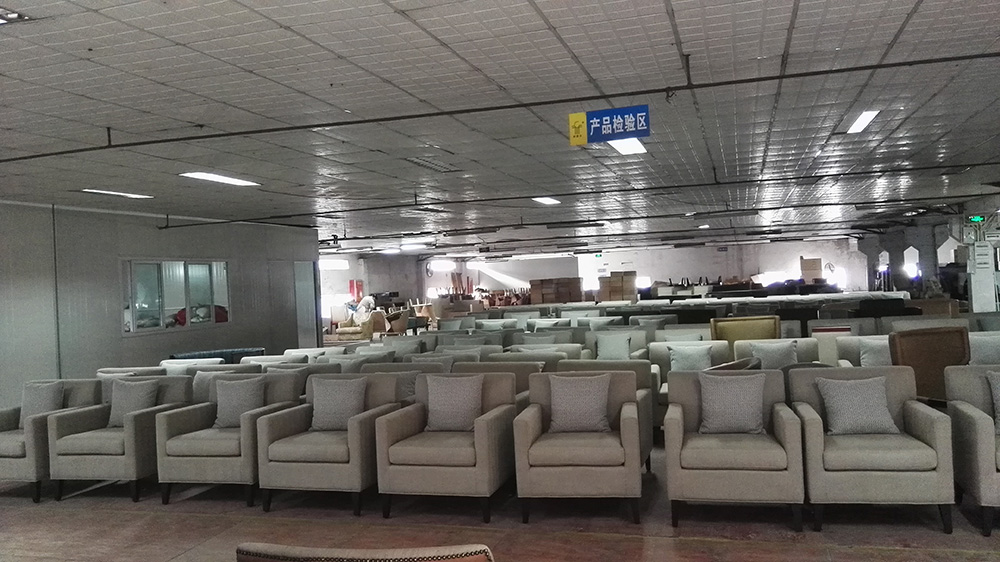

For a phased hotel renovation, the supplier may need to produce furniture continuously while the hotel is being renovated in stages.
That requires much more coordination than a single shipment for a completed new-build property.
For a phased renovation project, we recommend confirming several points before mass production.
Project Information | Why It Matters |
|---|---|
Total room quantity | Defines the overall production scope |
Rooms per phase | Determines batch production and delivery |
Room types | Prevents incorrect quantities or configurations |
Renovation sequence | Aligns furniture delivery with construction |
Fixed furniture scope | Helps coordinate site installation |
Loose furniture scope | Defines the factory production package |
Storage conditions | Determines when furniture can be shipped |
Site access | Affects unloading and installation planning |
Opening dates | Sets practical delivery priorities |
Design revisions | Prevents older specifications being used in later batches |
The total project quantity is important.
But for phased renovation, the quantity in each phase can be just as important.
When a hotel renovation lasts for two or three years, production cannot be treated as one completely independent order every time.
The first approved batch becomes the reference for later phases.
This means the supplier should maintain records of:
Approved drawings
Furniture codes
Material specifications
Finish references
Upholstery
Hardware
Dimensions
Approved samples
Production revisions
Without these records, later batches can slowly drift away from the original standard.
The furniture may still look generally correct, but differences in finish, fabric, dimensions or construction can become visible when the completed rooms are compared.
For a long renovation programme, consistency is a management issue as much as a manufacturing issue.
Not every hotel renovation is completed in one season.
Some projects are intentionally spread over several years.
This can happen because:
The hotel remains operational
Rooms are renovated in manageable batches
Different room types are scheduled separately
Fixed furniture requires additional site work
Public areas are handled independently
Budget is released in phases
Renovation work is coordinated with low-occupancy periods
We have seen this repeatedly in international hotel projects.
The Pathumwan Princess Hotel project in Bangkok is one example, with more than 200 rooms renovated progressively over around three years.
The project was divided into smaller room batches, while the inclusion of fixed furniture added to the on-site programme.
This type of project requires the furniture factory to remain aligned with a moving construction schedule rather than simply producing one large order and waiting for the hotel to open.
Long-term renovation partnerships can follow an even more unusual pattern.
At Grand Muthu Oura View Beach Club in Albufeira, Portugal, our furniture supply relationship has extended across roughly ten years.
Different floors and areas were renovated at different times.
Our supply history included furniture for:
35 rooms in 2015
49 rooms in 2021
15 rooms in 2023
45 rooms in 2024
30 rooms in 2026
That means a total of 174 room sets across five renovation phases.
This is not a single renovation order stretched over ten years.
It is a continuing hotel improvement programme in which different parts of the property are renewed at different stages.
For this type of project, the supplier needs to maintain a reliable historical product reference so that each new phase can be managed properly.
There is no fixed number of years after which every hotel should be renovated.
We have seen different patterns across projects.
Some hotels undertake another major renovation after around seven years.
Others remain in operation much longer before starting a new renovation programme.
One of our African hotel projects, for example, was renovated only after approximately 13 years.
The reason can depend on many factors:
Hotel positioning
Traffic level
Room condition
Ownership strategy
Investment budget
Brand requirements
Local market conditions
Previous renovation quality
For a furniture supplier, this means the relationship may extend well beyond the first order.
A hotel may return several years later and need the same product, a revised version, or a new furniture package for another area.
IWhat Happens If the Hotel Changes the Design Between Phases?
This is common in long-running renovation projects.
A hotel may begin with one approved design and later make changes because:
Materials are no longer available
A finish is updated
The brand standard changes
A particular product needs improvement
The owner changes the design direction
Another area of the hotel is being upgraded differently
The supplier should therefore distinguish between:
reproducing the original specification and developing a revised specification for a new phase.
The two should not be mixed.
When the design changes, the revised furniture should have its own controlled drawing, material reference and approval record.
Otherwise, production teams can easily manufacture from an older version.
Another point we see in hotel renovation projects is that the hotel may divide the furniture scope between several suppliers.
This can happen for commercial, geographical or project-management reasons.
For example, different suppliers may handle:
Loose furniture
Fixed furniture
Outdoor furniture
Upholstery
Decorative items
Different room types
Different areas of the hotel
This makes coordination more important.
The hotel does not simply need each supplier to manufacture its own furniture correctly.
The completed room still needs to look like one coordinated design.
That is why dimensions, finishes, material references and installation interfaces should be clearly agreed between the project parties.
For a furniture manufacturer, understanding what is being supplied by others can be just as important as understanding its own scope.
A sample is particularly useful when the hotel is being renovated over an extended period.
The sample provides a physical reference for:
Colour
Finish
Upholstery
Proportion
Dimensions
Construction
Material
It also gives the project team something that can be compared against the existing room environment.
This is important when the renovation is not happening all at once.
A hotel may approve a sample today and produce another batch many months later.
Keeping the approved reference is therefore part of maintaining continuity.
This is why we do not look at a phased hotel renovation as simply a furniture order.
It is a coordinated project with several connected stages:
Design
↓
Specification
↓
Sample
↓
Approval
↓
Production
↓
Quality Inspection
↓
Packing
↓
Phased Delivery
↓
Site Installation
↓
Room Inspection
↓
Hotel Reopening
If one stage falls behind, the following stages can also be affected.
For example, furniture may be completed in the factory but not yet needed on site.
Or the site may be ready while a revised furniture specification is still under approval.
The objective is therefore not simply to manufacture furniture as quickly as possible.
The objective is to have the right furniture, in the right quantity, at the right stage of the renovation.
Before the project begins, we recommend establishing:
1. The total renovation scope
Know which rooms and areas are included in the overall programme.
2. The phase structure
Define how many rooms or areas will be renovated at each stage.
3. The furniture scope
Separate loose furniture, fixed furniture and other interior packages.
4. The production schedule
Allow enough time for drawings, samples, materials, production and inspection.
5. The site schedule
Furniture delivery should follow actual room readiness rather than an arbitrary warehouse date.
6. The approval reference
Keep the approved sample and technical specification for later batches.
7. The change-control process
Any change to materials, dimensions or finishes should be recorded and approved before production.
This becomes increasingly important as the renovation programme extends over multiple years.
Many of our international hotel projects have involved renovation, refurbishment or furniture replacement rather than only new-build hotels.
They range from relatively concentrated room programmes to long-term, multi-phase projects.
The scale and schedule may differ, but the same principle keeps appearing:
The hotel renovation programme determines how the furniture programme should be managed.
For the Pathumwan Princess Hotel in Bangkok, more than 200 rooms were renewed progressively over several years.
For Grand Muthu Oura View Beach Club in Portugal, furniture was supplied across multiple phases over roughly a decade, covering different rooms, floors and areas.
Other hotels return for another furniture renovation after around seven years, while some properties may operate for more than a decade before undertaking another major renovation.
These different projects have taught us that hotel furniture replacement is rarely a one-off transaction.
It is often part of the hotel's longer operating life.
Hotel furniture replacement during renovation is usually not about changing one or two old pieces.
In a serious hotel refurbishment, the goal is normally to create a complete and consistent renewed room or area.
Because the hotel continues operating, the work is then divided into manageable phases.
One floor may be closed.
Then another.
One room block may be completed.
Then the next.
The furniture manufacturer needs to follow that sequence with the factory production, inspection, packing and delivery.
And when the project continues for several years, the supplier also needs to preserve the approved specification so that later phases remain consistent.
From our experience, the most important question is therefore not:
“How quickly can you replace the furniture?”
It is:
“Can you manage the furniture programme around the way the hotel actually renovates and operates?”
That is the difference between supplying furniture and supporting a hotel renovation project.
How are hotel furniture replacements usually phased during renovation?
Hotels commonly renovate by floor, room block, room type or defined area so that part of the property can remain operational. Furniture production and delivery then follow the renovation schedule.
Do hotels normally replace only a few pieces of furniture during renovation?
For a full guestroom renovation, it is generally more practical to renew the room as a coordinated package rather than mix a few new pieces with heavily aged furniture and finishes. The exact scope depends on the hotel's renovation plan.
Why do hotel renovations take several years?
The hotel may remain open during renovation, so rooms and areas are usually taken out of service in controlled phases. Fixed furniture and site construction can also make each phase longer.
How many hotel rooms are normally renovated in one phase?
There is no fixed number. Some projects may renovate around 30 rooms at a time, while larger or smaller batches may be used depending on occupancy, construction capacity and the hotel's operating requirements.
Can a hotel use several furniture suppliers during one renovation?
Yes. Different suppliers may handle different furniture categories or areas. Clear specifications and coordination are important so that the finished hotel remains visually and technically consistent.
How should a supplier manage a hotel renovation that lasts several years?
The supplier should retain approved drawings, material specifications, finish references, furniture codes, samples and revision records. These become the production reference for later phases.
Can hotel furniture be reproduced several years after the first order?
Often, yes, but the original specification and approved sample are important. If materials or hardware are no longer available, the supplier may need to develop an updated equivalent through a new approval process.
Does fixed furniture affect the renovation schedule?
Yes. Fixed furniture often requires coordination with walls, flooring, electrical work and other site construction. It can therefore require more site time than installing loose furniture alone.
