Hotel Furniture Lead Time: What Actually Determines Your Project Schedule?

Views: 46     Author: Site Editor     Publish Time: 27-08-2026      Origin: Site

facebook sharing button
linkedin sharing button
twitter sharing button
telegram sharing button
line sharing button
kakao sharing button
whatsapp sharing button
pinterest sharing button
sharethis sharing button

When a hotel furniture supplier says production will take 60 days, it is tempting to put 60 days into the project schedule and move on.

We would not recommend doing that.

Hotel furniture lead time does not start when furniture enters the workshop.

Before production begins, there may already be drawings to review, materials to confirm, samples to produce and approvals to obtain. After production, there is still inspection, packing, shipping and site delivery.

For an international hotel project, all of these stages form the real furniture lead time.

From our experience, the safest way to plan is to work backwards from the required delivery or room handover date rather than starting with the factory production period.

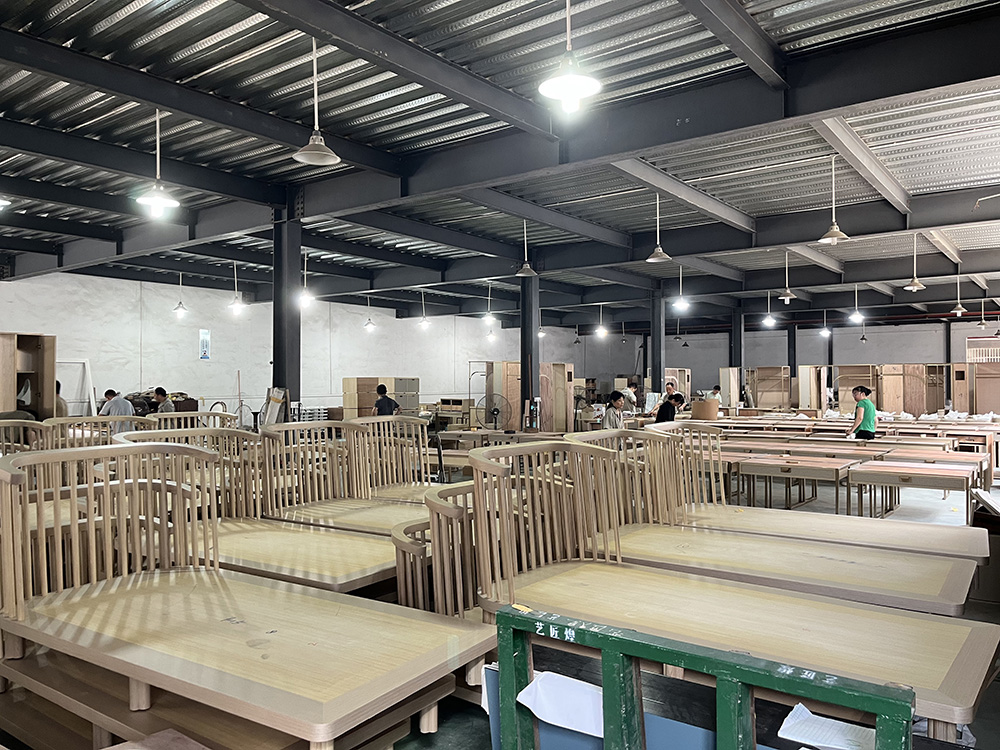

Hotel furniture production at a custom furniture manufacturing factory

Why the Production Time Is Not the Full Lead Time

A custom hotel furniture order normally passes through several stages before it reaches the site.

A typical process looks like this:

Design Confirmation

Shop Drawings & Technical Review

Material & Finish Approval

Sample Development

Sample Approval

Material Procurement

Mass Production

Quality Inspection

Packing

Shipping

Site Delivery

The exact duration varies from project to project.

The important point is that these stages are connected.

A delay at the beginning can push every stage that follows.

That is why we always look at the complete project timeline, not just the number of days required for manufacturing.

1. Design Confirmation Comes Before Production

The first question is simple:

Is the furniture design actually ready for production?

For a custom hotel project, the supplier may receive:

  • Furniture schedules

  • CAD drawings

  • 3D renderings

  • Material specifications

  • Finish schedules

  • Brand requirements

  • Reference images

These documents still need to be reviewed.

A design may look complete on a rendering but leave important manufacturing details unclear.

For example:

  • Exact dimensions may be missing.

  • A material may not be commercially available in the required format.

  • A joint or fixing method may need to be clarified.

  • A furniture piece may need adjustment to suit actual site conditions.

Starting production before these details are settled usually creates a bigger problem later.

Our view: time spent resolving uncertainty early is normally cheaper than time spent correcting furniture after production.

2. Shop Drawings Can Affect the Schedule More Than Expected

Shop drawings are one of the first major points where a furniture project moves from design into manufacturing.

A supplier needs to translate the design into practical construction details.

This may include:

  • Overall dimensions

  • Material thickness

  • Internal construction

  • Hardware

  • Joint details

  • Edge profiles

  • Upholstery details

  • Finishes

  • Installation requirements

For custom hotel furniture, this is not simply paperwork.

The shop drawing is where many production questions are answered.

If drawing approval takes two weeks longer than planned, production has effectively moved two weeks later.

This is why the drawing approval date should be treated as a real project milestone.

3. Materials and Finishes Can Add More Time

Custom furniture often involves materials that are not simply taken from existing factory stock.

The project may require:

  • Natural wood veneer

  • Solid timber

  • Special fabrics

  • Custom paint colours

  • Metal finishes

  • Stone

  • Glass

  • Rattan or cane

  • Special hardware

Some materials may need to be sourced specifically for the project.

Others may require sample approval before ordering larger quantities.

Natural materials also need additional attention because colour, grain and texture may vary.

For a luxury hotel project, the supplier should know the material requirements early enough to avoid discovering a sourcing problem after the production schedule has already started.

4. Sample Approval Is a Project Milestone, Not Just a Design Step

Sample approval for bespoke hotel furniture project

For bespoke hotel furniture, the production sample often becomes the reference for the complete order.

The project team may need to check:

  • Dimensions

  • Comfort

  • Materials

  • Colour

  • Veneer

  • Upholstery

  • Construction

  • Finish

Sometimes the first sample is approved immediately.

Sometimes it is not.

The designer may request a finish adjustment. The hotel may change a dimension. A detail may need to be simplified for production.

That is normal.

What matters is that the project schedule allows time for it.

Do not plan a hotel furniture project on the assumption that every first sample will be approved without revision.

A realistic programme leaves room for review and adjustment.

5. Material Procurement Should Run in Parallel Where Possible

Once the specification is sufficiently clear, material procurement should move forward.

Good project planning does not mean waiting for every single step to finish before starting the next one.

Where appropriate, the supplier can prepare:

  • Material purchasing

  • Production preparation

  • Hardware procurement

  • Fabric ordering

  • Production planning

in parallel with the final stages of approval.

This is where an experienced project team can save time.

However, materials should not be committed blindly before the design is confirmed.

There is a balance between moving quickly and moving too early.

6. Mass Production Is Only One Part of the Timeline

Once samples and specifications are approved, the project can enter mass production.

This is the stage most buyers usually focus on.

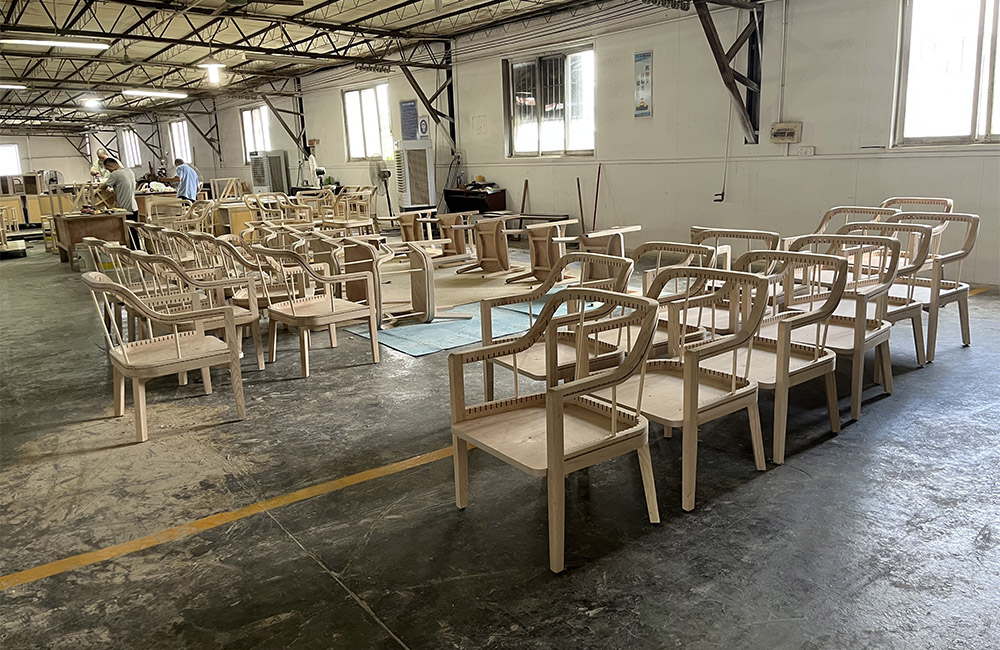

Custom hotel furniture mass production in Tongda factory

But the factory production period itself can contain several different operations:

  • Material preparation

  • Cutting

  • Woodworking

  • Veneering

  • Upholstery

  • Painting

  • Assembly

  • Hardware installation

  • Final finishing

Different furniture categories may move through different production routes.

A guestroom desk, upholstered lounge chair and outdoor side table are not manufactured in exactly the same way.

For a large hotel project, several furniture categories may therefore be produced at the same time in different workshop areas.

The production schedule needs to account for the complete package rather than one product at a time.

7. Quality Control Needs Time Too

Furniture should not be considered ready simply because manufacturing is complete.

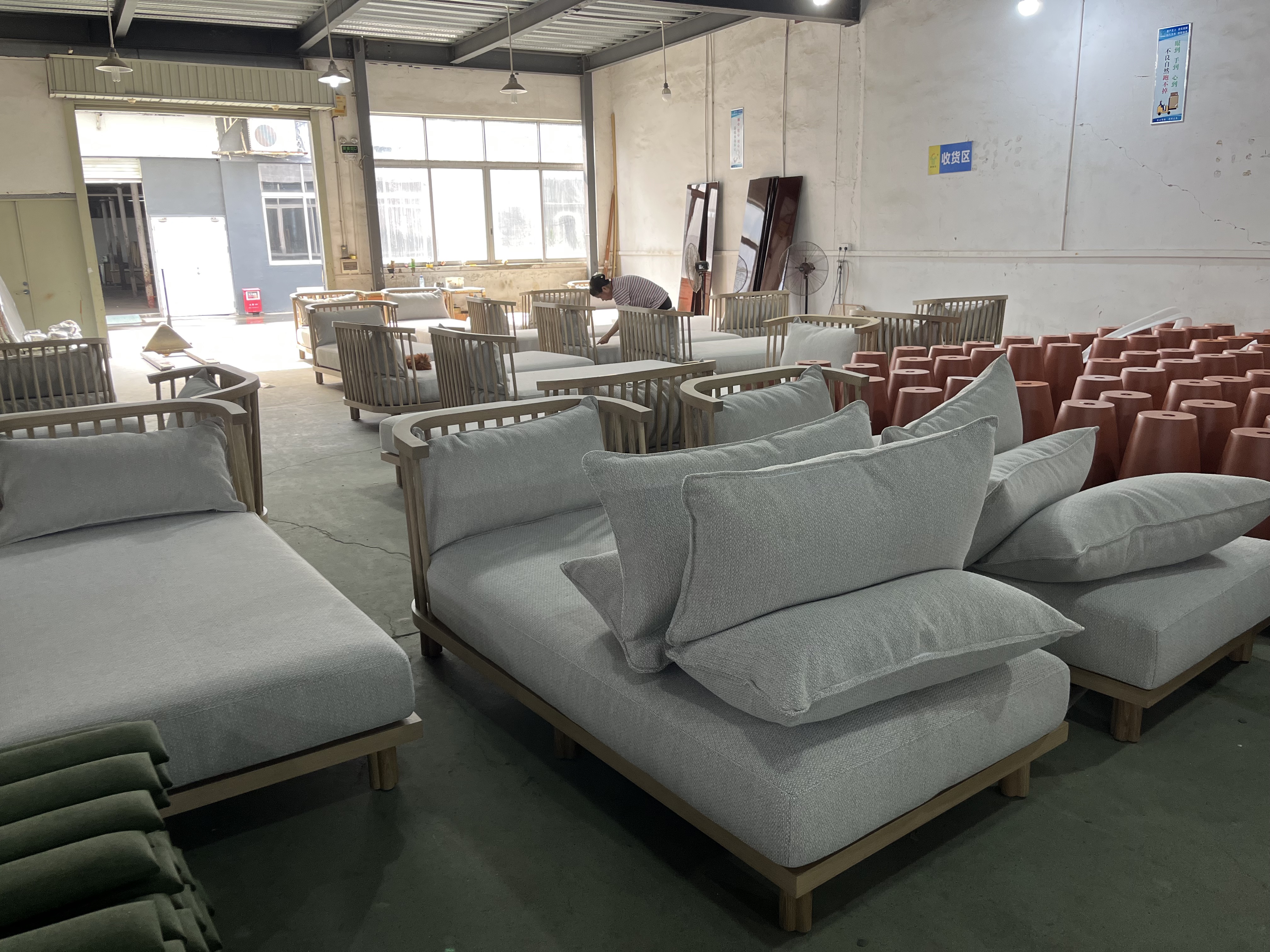

Hotel furniture quality inspection before international shipment

Before shipment, the supplier may need to inspect:

  • Dimensions

  • Surface finish

  • Colour consistency

  • Veneer matching

  • Upholstery

  • Hardware

  • Structural quality

  • General workmanship

Some projects also require comparison with the approved sample.

If defects are found, they need to be corrected before packing.

This is one reason we do not recommend using every available day for production and leaving no time before the shipping date.

A small quality issue discovered on the last day can become a major delivery problem.

8. Packing and Shipping Are Part of Hotel Furniture Lead Time

A common planning mistake is to treat factory completion as delivery.

They are not the same thing.

Once furniture leaves the production line, it may still need:

Final QC → Packing → Container Loading → Port / Forwarder Handling → Shipping → Customs → Local Delivery → Site Receiving

The exact route depends on the destination and shipping arrangement.

For international hotel projects, the furniture also needs suitable protection against:

  • Impact

  • Scratching

  • Moisture

  • Movement during transportation

This becomes especially important for large or delicate furniture pieces.

So when a buyer asks:

“How long does the furniture take?”

we normally think the better question is:

“When does the furniture need to be on site?”

The answer determines how much time is available for every stage.

When Should You Start a Hotel Furniture Order?

The safest approach is to work backwards from the project deadline.

For example:

Hotel Opening / Room Handover

← Site Delivery

← Shipping

← Packing & QC

← Mass Production

← Material Procurement

← Sample Approval

← Sample Production

← Drawings & Technical Approval

← Design Confirmation

← Supplier Appointment

This is much more useful than simply asking a factory for its production lead time.

A supplier may manufacture the furniture in a certain number of days, but your project schedule begins before that.

What Can Delay Hotel Furniture Lead Time?

Not every delay comes from the factory.

In our experience, the most common causes are often connected to decisions made before production.

  • Incomplete information

The supplier does not have enough information to finalise the design.

  • Slow drawing approval

Technical drawings remain under review while the production date continues to approach.

  • Material changes

The project team changes veneer, fabric, colour or hardware after the original specification.

  • Sample revisions

The first prototype requires changes before approval.

  • Late quantities

The room count or furniture schedule changes after production planning has started.

  • Site readiness

The furniture is finished, but the hotel site is not ready to receive or install it.

  • Shipping problems

The production date is met, but transportation creates additional lead time.

These are not always manufacturing problems.

They are project scheduling problems.

How We Plan Hotel Furniture Production at Tongda

For a custom hospitality project, Tongda's process generally connects:

Design Coordination

Shop Drawing

Sample Development

Material Confirmation

Production Planning

Manufacturing

Quality Control

Packing

Delivery

Our factory brings together specialist production areas including woodworking, upholstery, finishing and assembly. This allows different furniture categories to be planned within the same project rather than managed as completely separate orders.

For the client, the benefit is straightforward:

fewer gaps between design, production and delivery.

A Real Example: Furniture Delivery Before a New Hotel Opening

One Australian hotel project provides a useful example of why the complete timeline matters.

Mercure Melbourne Doncaster hotel room furniture project

Tongda was appointed for the guestroom furniture package during the pre-opening stage. The furniture needed to be completed before the hotel was ready to open, so the production schedule could not be considered separately from the overall construction programme.

The project required custom guestroom furniture rather than standard catalogue pieces.

That meant the schedule had to allow for:

  • Design coordination

  • Sample development

  • Production

  • Quality inspection

  • Delivery

The hotel subsequently opened as planned.

The lesson is simple:

The furniture deadline is determined by the hotel programme, not by the factory alone.

The hotel is Mercure Melbourne Doncaster, a new-build property in Australia with 183 guest rooms and suites. Accor's official material identifies it as a new-build hotel.

How Buyers Can Make the Schedule More Predictable

There are several practical things a project team can do.

  • Freeze the key specifications early

The earlier the major dimensions, materials and finishes are confirmed, the easier it is for the supplier to plan.

  • Allow realistic time for samples

Do not treat sample approval as a formality.

  • Review drawings efficiently

Keep comments consolidated where possible rather than sending repeated small revisions over several weeks.

  • Separate critical-path items from non-critical items

Some furniture may have longer material lead times than others.

  • Plan shipping from the required site date

Do not wait until production is complete before thinking about transportation.

  • Keep a decision owner

Someone should be responsible for approving drawings, materials and samples.

This avoids a simple question sitting unanswered while the production schedule moves closer.

Our View

We do not like quoting a single number for hotel furniture lead time without knowing the project.

A simple guestroom furniture order and a fully customised international FF&E package are not the same.

Neither are:

  • A new-build hotel

  • A phased renovation

  • A resort project

  • A multi-country project

  • A project with highly customised finishes

The production requirement can therefore be very different.

What we recommend is to build the schedule from the required on-site date backwards.

Once the milestones are clear, the supplier can tell you what is realistic.

That is a much safer way to plan a hotel furniture project than simply asking:

“How many days do you need to manufacture it?”

FAQ

How long does hotel furniture usually take to produce?

There is no single lead time that applies to every hotel project. The total schedule depends on design approval, shop drawings, materials, samples, production, quality control, packing and delivery.

Does hotel furniture lead time include shipping?

For project planning, it should. Factory production is only one part of the period between supplier appointment and furniture arriving on site.

When should I order custom hotel furniture?

Work backwards from the required room handover or hotel opening date. Allow time for design, drawings, sample approval, materials, production, QC, packing and shipping.

Can sample approval affect the hotel furniture schedule?

Yes. If the first sample requires revisions, production can move later. This is why sample development and approval should be included in the original programme.

Does custom hotel furniture take longer than standard furniture?

Usually, custom furniture requires more development because the design, materials, finishes and construction need to be confirmed specifically for the project.

Can different furniture categories be produced at the same time?

Yes. A capable hotel furniture manufacturer can plan different categories through different production areas and run them in parallel where the project allows.

What is the difference between production lead time and total hotel furniture lead time?

Production lead time is the period used for manufacturing. Total lead time includes the earlier stages such as drawings, materials and samples, as well as later stages such as QC, packing, shipping and delivery.

Contact us

FAQ

    Q Do Tongda hospitality accept customization?

    A
    Yes, we specialize in bespoke luxury hotel furniture. We can tailor furniture according to your drawings, design concepts, or specifications, with flexible options for materials, sizes, colors, and finishes.
  • Which countries do Tongda export to?

    Tongda hospitality furniture has been exported to numerous countries, including Germany, France, Italy, the United Kingdom, the United States, Saudi Arabia, Qatar, Portugal, Malaysia, Maldives, Singapore and beyond. With extensive international experience, we specialize in delivering high-quality, durable, and stylish furniture solutions tailored for the global hospitality industry.
  • Can Tongda meet the standards of international hotel groups?

    Yes, our products comply with the standards of major hotel groups like Marriott, Hilton,  and others. We have extensive experience supporting such hospitality projects.
  • What major design styles can Tongda produce?

    We are proficient in creating a variety of styles, including modern minimalist, classic European, luxurious Middle Eastern, natural Southeast Asian, and industrial vintage styles. We support custom style solutions based on client needs.
  • What types of clients do Tongda typically work with?

    We mainly cooperate with hotel owners, contractors, design companies, and project agents, and we also work with selected procurement companies and distributors. We are especially experienced in serving large-scale hotel projects, such as five-star hotels.
  • Do Tongda only handle large hospitality projects, or accept small batch orders as well?

    We mainly serve large hospitality projects, but we also accept small batch standard product orders (subject to minimum quantity requirements per product category). Please contact us for specific project inquiries.
Tongda's mission extends beyond creating beautiful furniture. We aim to be the cornerstone of memorable hospitality experiences across Europe and beyond.


Products

Products

Quick Links

Contact us
 86-0757-26671042
 86-13924801356 Daisy ; 86-13929153283 Benson
Wechat: 13924801356
 tongda222@163.net ; 13929153283@163.com
  ChaChong Industrial Zone,Beijiao Town,Shunde,Foshan,Guangdong,China

Copyright © 2025 Guangdong Tongda hospitality furniture. All Rights Reserved.  Sitemap
