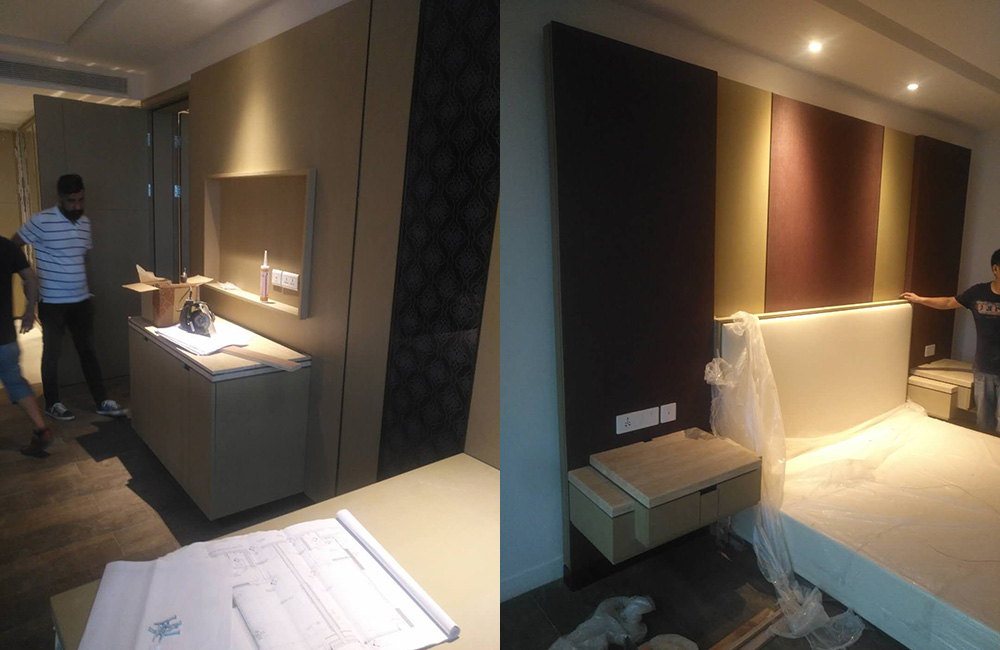

Hotel furniture installation should begin when the specific room or area is ready to receive and protect the furniture, not simply when the furniture is finished at the factory. The most important checks are site release, surrounding construction work, MEP interfaces, access, critical dimensions, protection, storage and installation sequencing.
This does not mean the entire hotel must be completely finished before furniture enters the building. On a large project, installation is often phased by floor, room block or functional area, and the relevant zone only needs to be sufficiently complete for the furniture work to proceed without creating avoidable rework or damage.
In hotel projects, “site ready” should mean more than “construction is nearly finished”.
It means the particular area receiving the furniture has reached a condition where the furniture can be delivered, installed and protected without being caught between unfinished trades.
For example, a guestroom may appear almost complete but still have:
Electrical points that have not reached their final location
Wall finishing still underway
Flooring that has not been protected
Ceiling or MEP work taking place above the furniture
Other contractors using the room for storage or access
Final dimensions that have not been confirmed
No agreed route for bringing large furniture into the room
Any of these can affect installation.
This is why hotel FF&E installation has to be coordinated with the construction programme rather than treated as a separate furniture activity. HVS describes FF&E installation as part of the wider hotel fit-out process and notes that the project manager coordinates construction activity, FF&E procurement and installation.
This is one of the most common gaps between furniture procurement and construction.

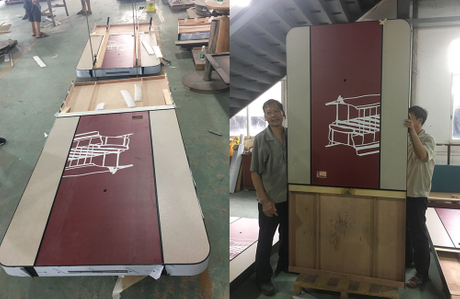

The factory may have completed production, passed inspection and prepared the shipment.
But the hotel site may still be waiting for:
Final electrical work
Flooring completion
Painting or wall finishing
Joinery interfaces
Lift access
Room release
Cleaning
Other contractor work to finish
These are two different schedules.
A recent hotel project case published by Cayuga Hospitality Consultants illustrates the problem clearly: the construction team and FF&E procurement team were working with different information, and critical construction milestones—including electrical inspection dates—had not been properly connected to FF&E requirements and installation.
The practical lesson is simple:
Furniture availability and installation readiness need to be managed as two connected dates.
The exact requirements depend on the furniture package and the project, but the following checks cover the issues that most often affect installation.
Site Readiness Check | What Should Be Confirmed |
|---|---|
Area release | The room or zone is available for furniture work |
Construction | Major work that could damage or obstruct furniture is complete |
Flooring and walls | Relevant finishes and interfaces are ready |
MEP | Critical services and connection points are confirmed |
Dimensions | Site measurements match the approved furniture requirements |
Access | Lifts, corridors, doors and loading routes are usable |
Storage | Secure temporary storage is available if required |
Protection | Finished surfaces and installed furniture can be protected |
Punch list | Relevant outstanding work has been addressed |
Installation sequence | Supplier and site teams agree on the order of work |
Responsibility | Site and furniture responsibilities are clearly assigned |
Not every project needs every item to be completely finished before installation. The key is understanding which conditions directly affect the furniture.
The first question should be:
“Is this room or area actually ready for furniture installation?”
For a new hotel, the answer may be organised floor by floor or by a defined room block.
For a renovation, it may be a group of rooms temporarily taken out of operation.
The release should come from the project team rather than relying on an informal message that a room is “almost done”.
This matters because furniture installation normally involves several people working in the same area. Once the furniture is inside, the room becomes more difficult to use for other construction activities without increasing the risk of damage.
Furniture should not enter a room while heavy dust, drilling, sanding, painting or similar work is still taking place around it.
That does not mean every trade must have left the hotel.
On large projects, different trades often overlap.
The practical question is:
Will the remaining work interfere with the furniture installation or put the finished furniture at risk?
For example, minor touch-up painting may be manageable with proper protection.
Drilling ceilings directly above newly installed upholstered furniture is a different situation.
This is also why FF&E scheduling cannot be separated from the construction programme. Hospitality project guidance recommends completing relevant General Contractor punch work before furniture installation to avoid overlapping trades and disruption.
A common mistake is to treat “finished” as a simple yes-or-no condition.
In reality, furniture installation often happens while some final work remains.
What matters is whether the surrounding surfaces have reached the stage required for the furniture being installed.
Check whether:
The final floor finish is installed where required
The floor is sufficiently level for the furniture
The finished floor height is known
The surface is protected from installation traffic
Check whether:
Final wall dimensions are established
Relevant finishes are sufficiently complete
Wall conditions support the required fixings
Skirting and trim positions are known
Wall panels and furniture interfaces have been coordinated
A fixed wardrobe, headboard or wall-mounted cabinet should not be installed against a wall whose final condition is still changing.
At the same time, there is no need to delay every loose piece of furniture simply because another part of the building has minor finishing work outstanding.
The installation sequence should follow the actual interface.
Hotel furniture often sits directly around building services.
A desk may contain or conceal power and data access.
A minibar cabinet may need electrical access and ventilation.
A headboard may integrate lighting.
A fixed vanity may coordinate with plumbing.

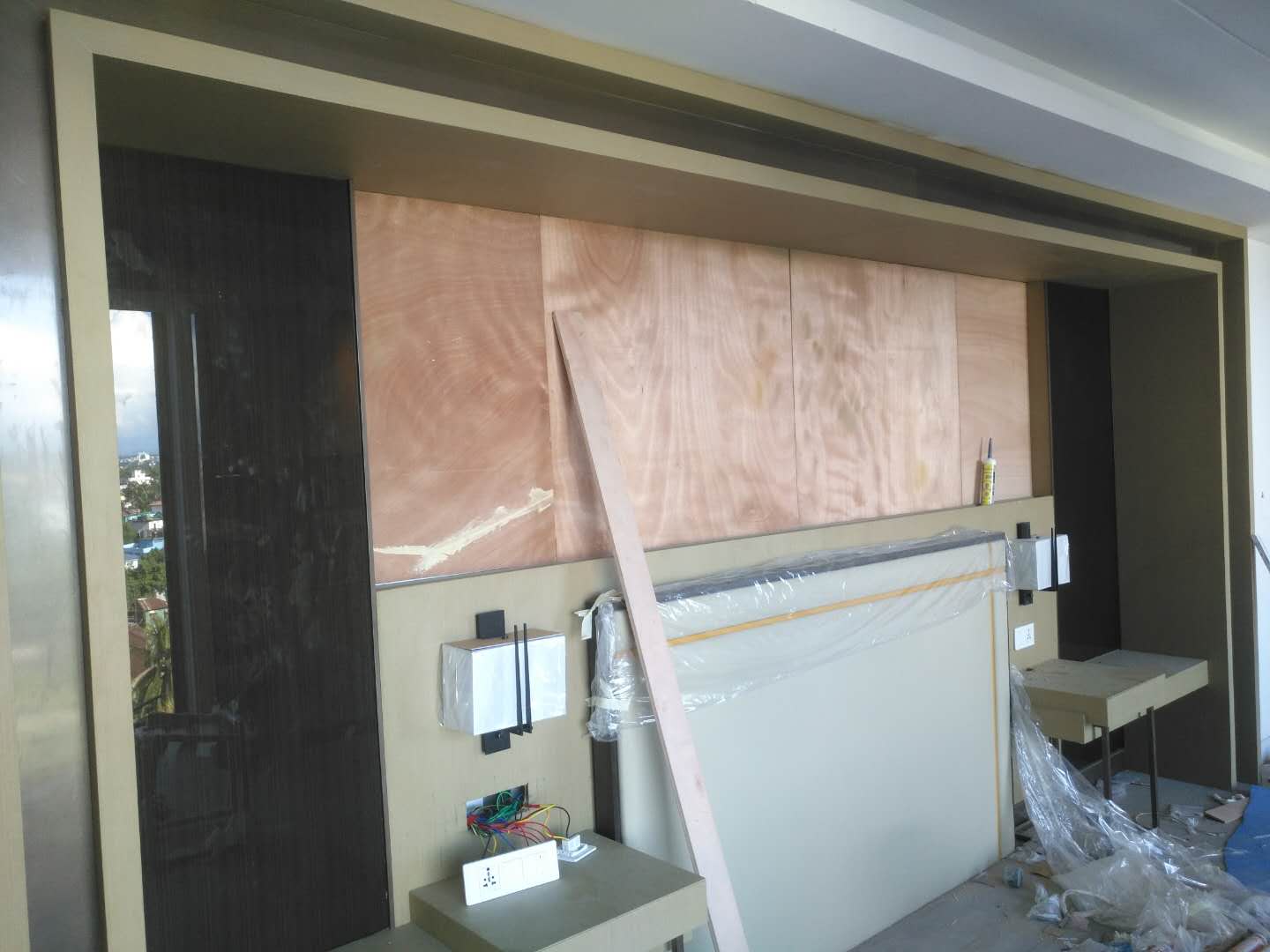

Before installation, confirm the relevant MEP positions.
These may include:
Electrical outlets
Data points
Lighting connections
Plumbing connections
Drainage
HVAC grilles or access
Other service openings
HVS notes that hotel MEP design is coordinated with architecture and interior design and that FF&E installation forms part of the wider fit-out process.
The important point for furniture teams is that the furniture drawing cannot be considered independently from the building.
Approved shop drawings are essential, but the final building condition still matters.
This is particularly true for fixed furniture.
Before installation, confirm critical dimensions where appropriate:
Wall-to-wall measurements
Floor-to-ceiling height
Built-in openings
Wardrobe locations
Desk and counter positions
Headboard dimensions
Door and drawer clearances
Furniture-to-wall interfaces
The supplier does not necessarily need to re-measure every piece of loose furniture.
The dimensions that can affect fit or installation should receive the most attention.
This is particularly important when the building is still being completed, because the actual site condition can differ slightly from earlier drawings.
Furniture can be correctly manufactured and still be difficult to install because nobody checked how it would reach the room.
Before delivery, confirm:

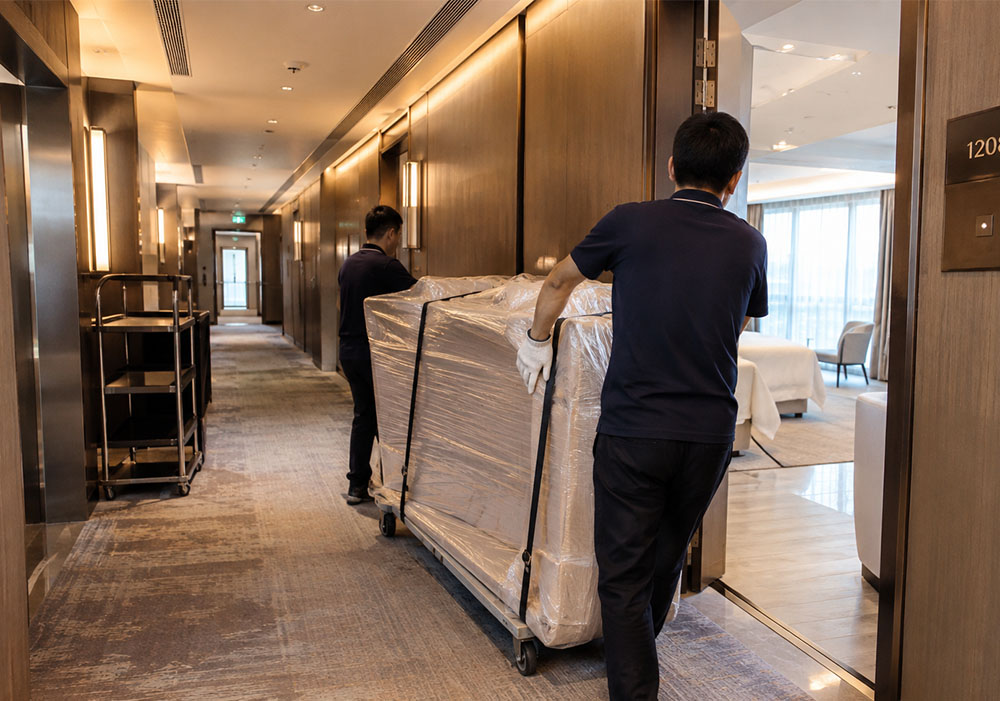

Loading access
Service entrance
Building doors
Corridor width
Service lifts
Lift dimensions and capacity where relevant
Stairs if required
Temporary storage areas
Large headboards, wardrobes, sofas and other oversized pieces deserve particular attention.
The question should be asked before the furniture is shipped:
Can the actual finished product physically reach its final position?
For an international hotel project, solving this at the factory or during logistics planning is considerably easier than trying to modify a finished piece after it reaches site.
Not every project allows direct delivery from truck to final position.
Sometimes furniture arrives before all rooms are ready.
In that case, secure storage becomes part of the installation plan.
The storage area should protect furniture against:
Moisture
Dust
Excessive heat
Construction damage
Unauthorised handling
Repeated movement
This is especially important for upholstered and finished timber furniture.
Moving the same furniture several times is not an efficient installation strategy. Every additional handling stage creates another opportunity for scratching, staining or damage.
That is why delivery timing should be connected to the actual installation sequence, rather than simply to the date the furniture leaves the factory.
Protection should not be improvised after installation.
Before the first furniture enters the room, the project should know how the furniture and surrounding finishes will be protected.
Depending on the project, this may include protection for:
Finished floors
Wall finishes
Door frames
Lift interiors
Furniture surfaces
Upholstery
Veneered panels
Glass and fragile components
The installation team should also know which areas can still be used by other trades after furniture has been installed.
Once a finished room contains furniture, the room condition becomes part of the furniture protection strategy.
New-build projects generally have more flexibility because the hotel is not yet operating.
Furniture installation can be planned by:
Floor
Room block
Guestroom type
Public area
Building zone
The project team can establish an installation sequence that follows construction progress.
However, the installation still needs to coordinate with MEP, inspections, access, commissioning and other FF&E activities. A hospitality FF&E consultant has specifically noted that design, delivery and installation need to remain aligned with the wider construction schedule.
Renovation is different.
A hotel normally does not shut the entire property just to replace furniture.
In practice, rooms or areas are often taken out of service in phases while other parts of the hotel continue operating.
That means furniture installation may need to follow a very specific rhythm:
Room block released → construction completed → furniture installed → inspection → protection → room returned to operation
Tongda's experience with the Pathumwan Princess Hotel in Bangkok is a good example. More than 200 rooms were renovated over roughly three years, with about 30 rooms handled in each phase. Because the package included fixed furniture, installation involved considerably more site coordination than simply delivering loose furniture into finished rooms.
This is the kind of project where furniture availability alone tells you very little about whether the installation can actually proceed.
The Grand Muthu Oura View Beach Club in Albufeira provides another example of why renovation planning has to be treated as a long-term process. Tongda supplied room furniture across several refurbishment phases over many years, with different floors and areas completed at different times. In that situation, the furniture package, production planning and delivery schedule all had to follow the hotel's phased renovation rather than one single installation date.
There is an important distinction here.
A project can still have outstanding work elsewhere in the building while furniture installation proceeds in one completed area.
The relevant question is:
Which outstanding items affect this furniture installation?
For example:
Outstanding Work | Effect on Furniture Installation |
|---|---|
Minor work in another floor | Usually no effect |
Final wall touch-up behind a wardrobe | Direct effect |
Electrical point not yet installed behind a desk | Direct effect |
Ceiling work above an upholstered room | Potential effect |
External landscaping | Usually no direct effect |
Corridor fire-door adjustment affecting delivery route | Potential effect |
This is a much more useful way to manage site readiness than simply waiting for the entire construction punch list to reach zero.
The responsibility depends on the contract, but it should be explicit.
A practical division may look like this:
Party | Typical Responsibility |
|---|---|
Owner / Hotel | Operational priorities and room release |
Project Manager | Overall schedule and coordination |
General Contractor | Construction readiness and site conditions |
Interior Designer | Design intent and finish coordination |
Furniture Supplier | Product-related installation requirements |
Installation Team | Furniture installation and reporting site issues |
The exact structure can differ from project to project.
What should not differ is the need for clear responsibility.
A recent hotel opening case showed how unclear boundaries between procurement, construction and installation responsibilities can become a major project problem. The procurement team was handling purchasing, while onsite coordination and installation responsibilities had not been clearly assigned.
A practical pre-delivery meeting should answer a few simple questions:
Which rooms or areas are being installed?
Are they formally released?
Are the critical MEP points complete?
Are the relevant dimensions confirmed?
Can the furniture reach the room?
Where will furniture be stored if the room is not ready?
Who is supervising installation?
Which contractor is responsible for any remaining site work?
How will finished furniture be protected?
What is the installation sequence?
If these questions have clear answers, the risk of avoidable site problems is considerably lower.
Site Check | Ready? |
|---|---|
Installation area has been formally released | ☐ |
Major damaging or obstructive work is complete | ☐ |
Relevant floors and walls are at the required stage | ☐ |
Critical MEP and electrical points are confirmed | ☐ |
Site dimensions for fixed furniture are confirmed | ☐ |
Access routes and lifts are available | ☐ |
Storage is arranged if direct installation is not possible | ☐ |
Floor and furniture protection is ready | ☐ |
Relevant punch-list issues are closed | ☐ |
Installation responsibilities are clear | ☐ |
Delivery date matches the installation sequence | ☐ |
Site contact and daily coordination process are confirmed | ☐ |
From the furniture manufacturer's side, the installation discussion should begin before the truck arrives.
We need to understand:
What areas will be released?
What is the installation sequence?
Which furniture is fixed and which is loose?
Are final site dimensions available?
Who is taking responsibility for site measurement?
Who handles unloading and movement?
Where can furniture be stored?
Who is responsible for installation?
How are site variations reported?
What protection is required after installation?
This is where hotel project experience makes a practical difference.
A furniture manufacturer is not responsible for completing the building, but the supplier needs to understand how its furniture interacts with the building and the installation programme.
No. Furniture installation can be phased by floor, room block or area. The specific installation zone needs to be sufficiently complete and protected for the furniture work to proceed.
Delivery should be coordinated with the planned installation window and the release of the relevant area. Delivering furniture too early can create storage, handling and damage risks.
The critical requirements usually include final site dimensions, relevant wall and floor conditions, MEP and electrical interfaces, access and installation sequence.
Yes, but the remaining work must not interfere with the furniture installation or create unnecessary damage risk. Construction and FF&E activities can overlap, but the sequence needs to be controlled.
Yes. Operating hotels often renovate by room block, floor or area so the rest of the property can continue operating. Furniture production and installation therefore need to follow the renovation phases.
Usually the project or construction team controls site readiness, while the furniture supplier controls furniture-specific requirements, delivery and its agreed installation scope. The contract should define the responsibilities clearly.
Because the actual building condition may differ slightly from earlier drawings. Fixed furniture is especially sensitive because it has to fit the completed room rather than an assumed dimension.
It can be, but only when secure and suitable storage is available. Direct delivery into a released installation area is generally simpler because it avoids additional handling.
Hotel furniture installation should be planned around site readiness, not simply furniture availability.
The hotel does not need to be completely finished before furniture arrives. What matters is that the specific installation area is sufficiently complete, accessible, coordinated and protected, with the building interfaces that affect the furniture already understood.
For new hotels, this means aligning furniture installation with construction and commissioning.
For operating hotel renovations, it means aligning furniture with phased room or area releases.
For the furniture supplier, the practical rule is simple:
Do not ask only when the furniture will be ready. Ask when the site will be ready to receive it.
That is where the factory schedule, construction schedule and installation schedule finally meet.
