Hotel furniture after-sales support should not necessarily end when furniture is delivered to the hotel. Depending on the project and contract, a supplier may also need to support warranty matters, replacement parts, technical questions, damaged items and future furniture reorders.
This becomes particularly important in hotel projects because furniture remains in daily use long after the original installation.
A chair may need a replacement component. A drawer runner may fail. A sofa cushion may require replacement. Several years later, the hotel may want to reproduce an existing furniture item for another floor or renovation phase.
These situations are very different from a standard furniture purchase.
Not necessarily.
The exact responsibility depends on the signed contract, warranty conditions and the supplier's agreed scope.
But from a project perspective, it is useful to think beyond delivery.
A hotel furniture project has at least three stages:
Project delivery
Furniture is manufactured, inspected, packed and delivered.
Hotel operation
Furniture is used, cleaned, maintained and occasionally repaired.
Future replacement
Individual components, complete furniture pieces or additional rooms may need to be reproduced later.
A supplier who understands the original project can be useful across all three stages.
That does not mean the supplier should automatically provide unlimited support.
It means the buyer should establish before the order is placed what support will remain available after handover.
Not every problem is a manufacturing defect.
Hotels operate furniture under conditions that are difficult to reproduce in a factory.
After opening, a hotel may encounter:
Accidental damage during housekeeping
Heavy wear on upholstery
Broken chair or table components
Damaged furniture finishes
Failed hinges or drawer runners
Sofa-bed mechanism problems
Lost or damaged hardware
Furniture damaged during room maintenance
Pieces that need to be reproduced during a later renovation
The first step is therefore to identify what happened, rather than immediately assuming that the entire product needs replacing.
A damaged hinge does not require a new cabinet.
A damaged chair leg does not necessarily require a new chair.
A worn cushion may be replaceable without replacing the frame.
That distinction can save time and reduce unnecessary replacement.
These are four different situations and should be treated differently.
Situation | Typical Action |
|---|---|
Minor damage | Repair or touch-up |
Failed component | Replace hardware or component |
Furniture no longer practical to repair | Replace complete item |
Same furniture needed years later | Reproduce the original item |
For example, a hotel may need new:
Chair glides
Hinges
Drawer runners
Sofa-bed mechanisms
Castors
Cushion covers
Table legs
Small hardware components
For custom furniture, identifying the correct replacement can be more difficult than it sounds.
A standard replacement part may not fit.
The original furniture may use a particular hardware model or construction detail.
This is where the manufacturer's original project records become useful.
A complete project should leave behind more than an invoice.
For future support, the supplier should ideally retain:
Project Record | Future Use |
|---|---|
Product code | Identifies the exact furniture |
Approved drawing | Reproduction reference |
Final dimensions | Confirms the original specification |
Material specification | Prevents incorrect substitutions |
Finish reference | Supports visual continuity |
Fabric reference | Helps with upholstery replacement |
Hardware specification | Identifies replacement components |
Approved sample photos | Visual reference |
Revision records | Shows which version was finally approved |
Production photos | Useful for construction reference |
This is particularly important for bespoke hotel furniture.
Five years later, nobody should have to rely on:
“It looked something like this.”
The better reference is:
“This was the approved product, made to this drawing, with this material and this finish.”
That makes future reproduction much more controlled.
Hotels often assume that once a furniture supplier has made a product, reproducing it later will be straightforward.
Not always.
Several things may have changed.
The original fabric may have been discontinued.
A veneer supplier may no longer carry the same material.
The original hardware may have been replaced by a newer model.
The finish may have been adjusted.
Even the factory's production team may have changed.
This is why long-term project records matter.
A future reorder should begin with the original project information rather than with a new quotation based only on photographs.
Where the original material is unavailable, the supplier can then determine whether the project requires:
the closest available material or a new approved specification.
That decision should be made before production.
Warranty conditions should always be based on the signed contract.
The buyer should confirm:
Warranty period
What is covered
What is excluded
Whether accidental damage is covered
Whether normal wear is covered
How claims are reported
Who assesses the problem
Whether replacement parts are available
How transport costs are handled
This distinction matters because normal hotel wear is not automatically the same as a manufacturing defect.
A structural problem under normal use may be treated differently from damage caused by moving a heavy piece of equipment through a room.
Clear documentation makes these situations much easier to handle.
For Tongda's exported hospitality furniture, our currently published policy states a 1–2 year warranty covering structural issues under normal use, with detailed terms determined by the signed contract. We also publish installation guidance and support for transportation-damage claims where applicable.
Sometimes, yes.
But the decision should be based on the type of furniture and the likely replacement difficulty.
It makes more sense to keep a small stock of components that are:
Small + frequently used + difficult to source quickly.
Examples can include:
Hinges
Drawer runners
Chair glides
Castors
Sofa-bed mechanisms
Selected fixings
Replacement cushion covers
It is less useful to stock large quantities of complete furniture simply because it might be needed someday.
For most hotel projects, a clear record of the original specification is more important than maintaining a large physical spare-furniture inventory.
A hotel may have hundreds of rooms and several similar-looking furniture pieces.
Without product codes, a maintenance team may describe something simply as:
“the chair in Room 508”
That is not enough information for a manufacturer.
A useful system identifies:
Furniture code → Product type → Drawing → Material → Finish → Hardware
This makes communication much faster.
It also becomes valuable when different room types have slightly different versions of the same furniture.
For example, two bedside tables may look almost identical but have different dimensions or hardware.
The supplier needs to know which version is being discussed.
Often, yes, provided sufficient project information remains available.
But reproduction does not always mean making an absolutely identical piece.
Older furniture may have aged.
Timber finishes change with exposure to light.
Fabrics can become discontinued.
Some materials are no longer commercially available.
In those cases, the supplier may need to establish a revised specification.
There are two different objectives:
Reproduce the original specification
or
Create a current equivalent that works with the existing hotel.
The hotel, designer or owner should make that decision before the supplier starts production.
Our experience with renovation projects shows why after-sales support should be viewed over the life of the property rather than only the original delivery.
At Grand Muthu Oura View Beach Club in Albufeira, our cooperation has continued through multiple renovation phases from 2015 to 2026. The documented supply includes 35 room sets in 2015, 49 in 2021, 15 in 2023, 45 in 2024 and another 30 in 2026, totalling 174 room sets.
This is a good example of why historical furniture records matter.
The hotel did not need to start from zero every time another group of rooms was refurbished.
Previous furniture requirements provided a reference for later phases.
The Pathumwan Princess Hotel project in Bangkok followed a different model.
More than 200 rooms were renovated progressively over approximately three years, with smaller batches of around 30 rooms. Because the project included fixed furniture as well as loose furniture, site work was closely connected to the renovation programme.
For projects like this, support is not just about warranty claims.
It is also about maintaining consistency between phases.
The supplier needs to know which specification belongs to which phase and which revision has been approved.
Tongda's project page records the guestroom furniture scope and the use of custom manufacturing with attention to materials, finishes, construction and functionality.
The Mercure Melbourne Doncaster project in Australia was a more concentrated guestroom furniture package.
Tongda supplied customised guestroom furniture including headboards and wall-panel elements, bedside tables, lounge furniture, chairs, ottomans, side tables and workspace furniture.
The project was completed in 2021 ahead of the hotel's opening in March 2022.
For this type of project, the same principle applies.
If a hotel needs additional or replacement pieces later, the value of the original supplier is partly in its understanding of the original product specification.
The hotel should not have to rediscover every material and dimension from the beginning.

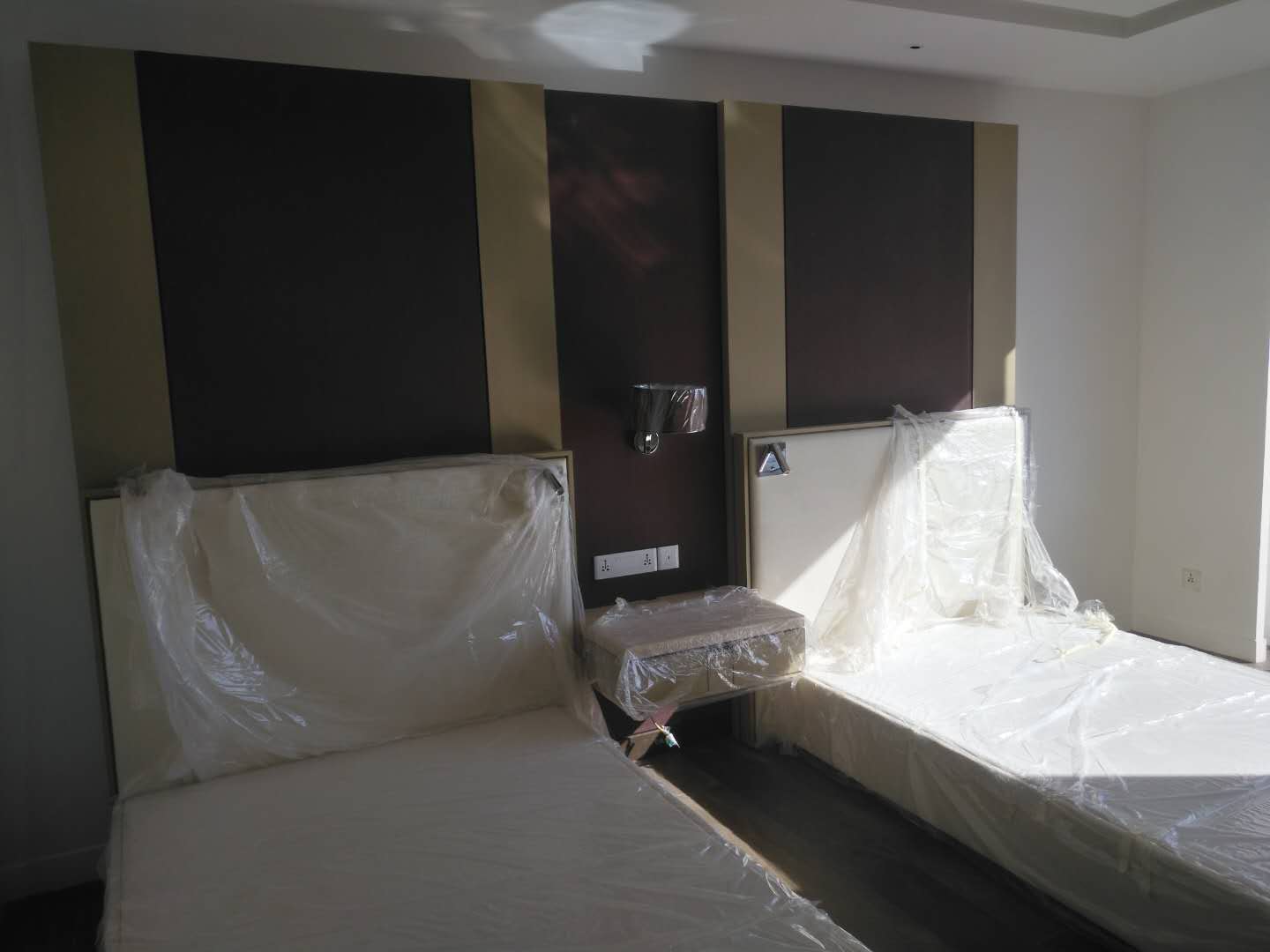

The Courtyard by Marriott Siliguri project is another useful example.
The scope included 56 King Rooms, 28 Twin Rooms and public areas.
Tongda's role included custom furniture manufacturing, sample approval and installation support, including a factory mock-up and on-site installation guidance.
This shows why “after-sales support” should not be treated only as a warranty department.
In some projects, the useful support may be technical:
Installation questions
Product identification
Adjustment guidance
Replacement information
Clarification of original specifications
The exact responsibility still depends on the project contract.
Guestroom furniture and public-area furniture do not necessarily have the same maintenance pattern.
A lobby chair may receive considerably more daily use than a guestroom chair.
A restaurant table can experience constant cleaning and impact.
A lounge sofa may need upholstery work without replacing the frame.
Our Hyatt Centric Ginza Tokyo project focused on bespoke furniture for the lobby and restaurant/bar areas. This type of public-area scope shows why future maintenance should be considered according to how the furniture is actually used, not simply by product category.
The same logic applies to other international projects with broad hospitality scopes.
At Sandals Saint Vincent and the Grenadines, Tongda supplied bespoke furniture and hospitality millwork across 100 guestrooms and suites, lounges, restaurants and public areas, with additional technical considerations for a tropical coastal environment.
A maintenance or replacement strategy for such a project naturally needs to consider different environments and different furniture applications.
A particularly interesting issue occurs in hotels where furniture forms part of a strong architectural identity.
At Muthu Alexandra Hotel in Oban, Tongda supplied bespoke guestroom furniture designed to work with the property's Victorian character.
When furniture is closely tied to the architecture, future replacement is not simply about finding something with the same function.
Proportion, finish, upholstery and overall character can all matter.
Maintaining the original project reference therefore becomes part of preserving design continuity.
For a substantial hotel project, we recommend keeping one organised digital project file containing:
1. Approved drawings
The final approved production version, not earlier revisions.
2. Final material schedule
Include the actual materials used.
3. Finish references
Keep stain, paint, veneer and other finish information.
4. Upholstery references
Keep fabric or leather codes and supplier information where available.
5. Hardware schedule
Record hinges, runners, mechanisms and other replaceable components.
6. Product codes
Every recurring item should have an unambiguous reference.
7. Approved sample photographs
Keep clear photographs of the final approved sample.
8. Warranty documentation
Record the contract terms and claim procedure.
This file becomes particularly valuable when the hotel begins its next renovation cycle.
Not every maintenance issue requires the manufacturer.
The hotel can normally handle simple routine maintenance internally.
The original supplier becomes more useful when:
A structural component fails
A custom mechanism needs replacement
A specific finish needs repair
The original furniture needs to be reproduced
A discontinued material needs to be matched
A large group of identical items needs replacement
A new renovation phase is being planned
The earlier the supplier is involved in these cases, the more information is available to work from.
Before awarding a hotel furniture project, ask:
Question | Why It Matters |
|---|---|
What is the warranty period? | Establishes contractual coverage |
What does the warranty cover? | Avoids assumptions |
Can replacement parts be supplied? | Helps with operational maintenance |
How are damaged items handled? | Defines the claims process |
Are project drawings retained? | Supports future reproduction |
Are material and finish records retained? | Helps maintain consistency |
Can the original furniture be reproduced later? | Important for renovation |
Is technical installation support available? | Useful for complex furniture |
Who pays for replacement transport? | Clarifies total cost |
Who is the after-sales contact? | Gives the hotel a clear point of contact |
These questions take little time before the contract is signed.
They can save considerably more time later.
We do not think after-sales should be treated as simply:
“The furniture has a warranty, so the project is finished.”
For custom hospitality furniture, the more useful long-term relationship is based on understanding the original project.
That means knowing:
what was produced
how it was produced
which materials were approved
which version was installed
what components were used
what can be reproduced
what would need to be redesigned if the original materials are no longer available.
That information is valuable to hotel owners and operators when the property reaches its next maintenance or renovation cycle.
Hotel furniture is a long-life project asset, not a one-time purchase.
Some furniture will simply continue operating for years.
Some pieces will need repair.
Some components will need replacing.
And eventually, a hotel may return to the original supplier for another renovation or a new production run.
Good hotel furniture after-sales support therefore starts with more than a warranty.
It starts with good project records, clear product identification and a supplier who understands what was actually manufactured.
Our experience across guestroom projects, public-area furniture, large bespoke orders and long-term renovation programmes has reinforced one point:
The best time to prepare for future furniture replacement is during the original project.
Keep the drawings. Keep the material references. Keep the approved sample. Keep the product codes.
Five or ten years later, those records can be more valuable than a photograph of the finished room.
What does hotel furniture after-sales support include?
Depending on the contract, it can include warranty handling, technical support, replacement parts, repair guidance, transportation-damage assistance and future furniture reproduction.
How long should hotel furniture warranty last?
There is no universal period. The warranty should be clearly defined in the signed contract, including the coverage, exclusions and claim procedure.
Can hotel furniture suppliers provide replacement parts?
Many custom furniture manufacturers can provide replacement components, particularly when the original hardware and production records have been retained. Availability depends on the product and the original specification.
Can a hotel order the same furniture again several years later?
Often, yes. The process is easier when the original drawings, materials, finishes, hardware and approved sample records have been retained.
What should a hotel keep from its original furniture project?
At minimum, retain approved drawings, product codes, final material and finish specifications, upholstery references, hardware information, sample photographs and warranty documents.
Is normal hotel wear covered by furniture warranty?
Not necessarily. Warranty coverage depends on the contract. Normal wear, accidental damage and manufacturing defects should be defined separately.
Should hotels keep spare furniture after a project?
A large stock of complete furniture is not always necessary. For selected high-use or difficult-to-source components, however, keeping spare parts can be practical.
Can the original supplier support a future hotel renovation?
Yes, where the supplier retains the relevant project records and the future scope is agreed. Previous project information can make reproduction or further customisation much easier.
